Official project interface · evidence and delivery

Gyumri–Kars

The Armenian Gyumri–Akhurik section and its connection to Türkiye: the corridor, railway systems and decisions needed before international trains can run.

Status note · 8 Sep 2026. Design procurement has been announced. This independent planning interpretation is not a tender specification, approved budget or operating agreement. The diagrams explain corridor logic and technical conditions; the opening date remains unknown.
official project stage
LIVEArmenia has moved the Armenian section beyond a study-only concept and into design procurement
≈21 kmPublicly reported Armenian Gyumri–Akhurik section to be restored and designed
Doğukapı–AkhuryanTCDD lists this border crossing as a closed international rail connection
1520 ↔ 1435The link connects Armenia’s broad-gauge network to Türkiye’s standard-gauge network

Evidence audit

What is actually confirmed

The point is not to make the project look more certain than it is. The point is to make the known parts easy to read and the unknown parts impossible to miss

28 Apr 2026 · official

Joint working group met in Kars

Armenia and Türkiye held a joint working group meeting specifically on rehabilitation and operationalization of the Gyumri–Kars railway

official network status

Cross-border rail interface exists

TCDD’s network statement identifies Doğukapı–Ahuryan as a closed border-crossing railway interface connected to Armenia

network difference

Gauge change is real

Armenia uses 1520 mm broad gauge while Türkiye uses 1435 mm standard gauge

still unresolved

Design details remain open

Track geometry, exact works scope, handling logic, funding structure and operating arrangements still await the official design phase

The corridor

The corridor and its interfaces

Follow the connection from Kars to Gyumri, the border procedures and the gauge interface. These are explanatory diagrams, not surveyed alignments.

Corridor geography

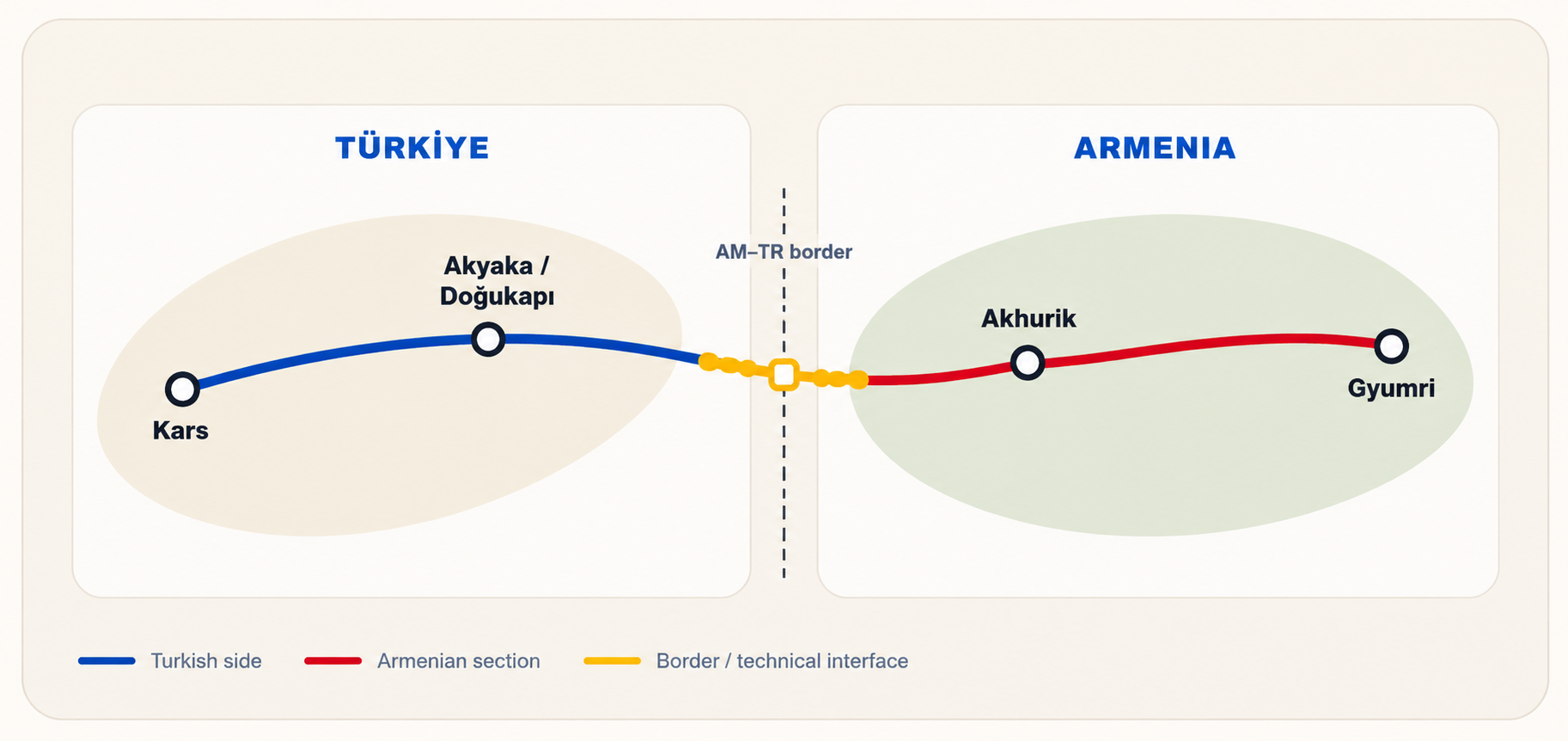

Local corridor map

A schematic corridor view showing Kars, Akyaka / Doğukapı, the border interface, Akhurik and Gyumri. It does not show a final engineered alignment

Kars — Akyaka / Doğukapı — Armenia–Türkiye border — Akhurik — Gyumri
Turkish network side Armenian design / restoration section Border interface Border / technical node Stations / rail nodes
Readiness logic

How the connection works

The corridor combines infrastructure restoration, a border crossing and an interface between two railway systems. Each part has to be ready before an international service can operate.

01
Map the corridor clearly

Show the geography and the cross-border relationship

02
Avoid false precision

Do not invent final geometry, signalling or station layouts

03
Explain the technical break

The gauge interface is one of the defining conditions of the project

04
Keep the delivery logic visible

The tender is important, but it is still one step on the way to service

Operational sequence

Operational chain

The operational sequence from Kars to Gyumri, separating the railway, border and technical interfaces

NODE 1 NODE 2 NODE 3 NODE 4 NODE 5 Kars Akyaka /Doğukapı Border Akhurik Gyumri regionalTurkish railnode border-sideTurkishinterface customs +technical +operatinginterface Armenianborder-siderail area Armeniannetwork entrypoint
Gauge interface

1520 mm meets 1435 mm

The principal technical interface between Armenia’s 1520 mm system and Türkiye’s 1435 mm system

ARMENIA1520 mmbroad gauge TÜRKİYE1435 mmstandard gauge INTERFACE ZONEtransferbogie exchangegauge change
Technical options

What the interface may require

The interface has several technically plausible solution families. The official design process must compare them and select the operating arrangement

Option family A

Transshipment terminal

  • Passengers or freight transfer between systems
  • Operationally simple to explain
  • Could add handling time and terminal requirements
Option family B

Bogie / wheelset exchange

  • Rolling-stock interface handled at a technical point
  • Useful where through movement matters
  • Needs suitable facilities, procedures and equipment
Option family C

Gauge-changing / dual-gauge approach

  • A more infrastructure-heavy response
  • Potentially powerful but design-dependent
  • Best kept open until official design narrows the field

What can be shown now

  • That the line reconnects two different railway gauges
  • Where the interface question belongs in the corridor
  • That multiple technical solution families are possible
  • That the final choice has operating, border and terminal implications

What should remain open

  • The exact location and layout of interface facilities
  • Which solution is preferred by the official design team
  • Whether freight, passengers or both are treated first
  • Detailed infrastructure and procurement consequences
Readiness sequence

From tender to service

The announced design stage is material, but operation still depends on surveys, engineering, procurement, works, testing and bilateral border arrangements

STEP 1

Design procurement

The project enters official design work on the Armenian section and defines the terms for survey, engineering and corridor decisions

STEP 2

Survey + existing-condition audit

The line, structures, formation, crossings, station areas and technical constraints must be measured and assessed rather than assumed

STEP 3

Engineering + gauge-interface choice

The design team has to determine what the restored line includes and how the 1520 / 1435 system break is handled

STEP 4

Construction procurement

Only after design can the Armenian side move to a construction tender and a clearer funding / delivery structure

STEP 5

Rehabilitation + testing

The corridor would then need works, systems installation, testing, certification and practical operating readiness

STEP 6

Border & operating agreement

Service needs more than track. Border procedures, operator arrangements and practical train-handling rules all have to work together

The core message

The corridor can and should be visualized, but it should be visualized as a carefully framed reconstruction-and-interface project rather than as a finished engineering design

Project status

Corridor diagram: schematic
Future engineering solution: pending official design
Opening date: not yet known

Sources & grounding

Primary references used here

The diagrams are schematic interpretations of the public sources below; they are not official engineering drawings

  1. Ministry of Foreign Affairs of Armenia — Regarding the Meeting of the Joint Working Group between Armenia and Türkiye for the Rehabilitation and Operationalization of the Gyumri-Kars Railway, 28 April 2026
  2. TCDD 2025 Network Statement, Annex 3.2.2 — lists Doğukapı–Ahuryan as a closed border-crossing railway interface and identifies Armenia’s network as 1520 mm broad gauge
  3. Public ministerial reporting cited in Armenian media about the international design procurement process for the Armenian Gyumri–Akhurik section and the sequencing of design first, construction later
